ScrapBuilt / WORKSHOP PLANS

WOF-100C / BABINGTON CRUCIBLE FURNACE

Rev C — not yet built or fire-tested

Furnace V1 Waste-Oil Foundry Plans (Rev C)

Rev C design package, not yet built or fire-tested. Drawn, calculated and checked by two automated (AI-run) design reviews; not yet built, wired or fired. Founder buyers get a free update to the first field-built revision.

Plans for a known-source used-oil crucible furnace built from a 30-gal drum, salvage and purchased parts, with a UV/safety-relay flame-safety chain designed in. Designed for 5 kg aluminium / 7 kg brass. Rev C design package, not yet built or fire-tested. Use code FOUNDER25 for 25% off Plans or Pro, first 25 orders.

One-time digital download · Metric drawings · Outdoor use only

Rendered cover of the WOF-100C furnace plans
THE BUILD GUIDEREVISION C / DIGITAL PLANS

READ BEFORE YOU BUY

A design. Still awaiting its first build.

Rev C design package, not yet built or fire-tested. Checked by two automated design reviews (findings fixed on paper). The control wiring must be reviewed by a qualified person, and the bench fault tests with the fuel disconnected are required before any firing.

  • Control wiring not approved: the actual relays, safety-relay inputs, air-switch poles and terminal assignments are not yet selected or reviewed. A qualified person must review the control wiring before anything is wired or powered with fuel. No certified burner safety is claimed.
  • Bench fault tests (fuel disconnected) before any firing: UV flame sensing, early and in-run flame loss, welded-relay faults, shutdown timing and a separate leak test of each oil valve must all pass on the bench with the fuel disconnected. The roughly 17 mL of oil released on a shutdown is a model figure until the timing is measured.
  • Fuel-line cold-flow test, compressor and blower: the gravity oil feed is designed to work down to 5 °C oil with a thin margin. Measure the clean-oil flow with cold oil at minimum tank level on your final hose route, and check connectors for leaks, the real compressor and blower performance, the atomizing air flow, the spill-bund volume and the site clearances. Scavenged hardware must pass the measured tests.
  • Lid and lifting proof tests: check the actual crucible fit and mass, proof-test the complete lifting tools at 25 kg, rehearse a dry transfer, and test lid clearance, droop, latch and push before use. Brass needs two people; never lift more than 12 kg in total.
  • Refractory dry-out and temperatures: the datasheets of the products you actually buy govern. Use a suitable dry-out heat source that is not the oil burner, follow the slower schedule, and confirm chamber ≤ 1200 °C, shell hot spots ≤ 250 °C and lid skirt ≤ 450 °C; inspect erosion and lid retention after cycling. Brass-duty margins are conditional, and no efficiency has been measured.
  • Charging workflow: every lid-open addition needs the full stop, purge and restart sequence, which depends on commissioned controls. Warming cans never proves hidden cavities are dry. Stop for the day after a second unplanned lockout.
  • Structure: welding on the thin drum sheet is avoided by design, but the real structural welds, bolts and all added brackets and tools still need inspection.
  • Costs are estimates: about $1,556 scavenged / $2,840 bought (2026 USD, PPE included), $257 / $731 more than Rev B. Real control parts, a dry-out heat source, local materials, shipping and tax can push this up; get real quotes before buying.

The 8 open risks after Rev C, from the fix log (section D) at the end of the plans.

Buyers who build it are early builders.

01 / ON THE BENCH

From first read to drawing sheet.

Plans PDF

  • Drawings: 26 A3 sheets: cover/index + 25 drawings with part numbers and title blocks (Rev C).
  • Build guide: stand and lid lift, shell, lining, dry-out, burner, oil/air/controls, cold and hot commissioning tests, first fire, tuning, melting, planned stop and hot restart, flame-out and lockout recovery, shutdown, maintenance, troubleshooting.
  • Safety section: waste-oil fire and flash risk, flame-out and fuel shutoff, CO and outdoor-only use, steam explosions, PPE, oil contaminants, electrical, hot metal and lifting, stop conditions, pre-run checklist.
  • Engineering numbers (first-order model estimates, about ±30 %):
    • Power: 12 / 25 / 38 kW.
    • Aluminium 5 kg: about 49–76 min from cold, 17–28 min hot.
    • Brass 7 kg: about 69 min cold / 23 min hot, high fire only.
    • About 3.2 L of oil for a cold aluminium melt.
    • Oil feeds down to 5 °C.
  • Fuel: filtered used engine oil from a known, traceable source. The guide says to reject oil of unknown origin.
  • Parts list: 85 lines. About $1,556 by the scavenged route ($1,310 build + $246 PPE) or about $2,840 bought, using the cheapest buy route (it includes some used/surplus items). These are 2026 estimates, not quotes. Even the scavenged route includes purchased castables, blanket, firebricks, compressor and flame-safety controls (about $405 of controls scavenged, $793 bought).

Pro: everything in the Plans PDF, plus

  • 26 DXF files, WOF-C-D00 cover/index + D01–D25 (R2010, mm, layered): DXF drawing files for CAD and quoting, and for your own edits. They are not prepared for direct machine cutting.
  • Parts spreadsheet (.xlsx and .csv): all 85 lines with part numbers, Rev C status, quantities, scrap source, cheapest buy option, scavenged and bought line costs, category and notes. Set your own prices and the totals update.
  • README with a file index, units and the sheet-to-part map.

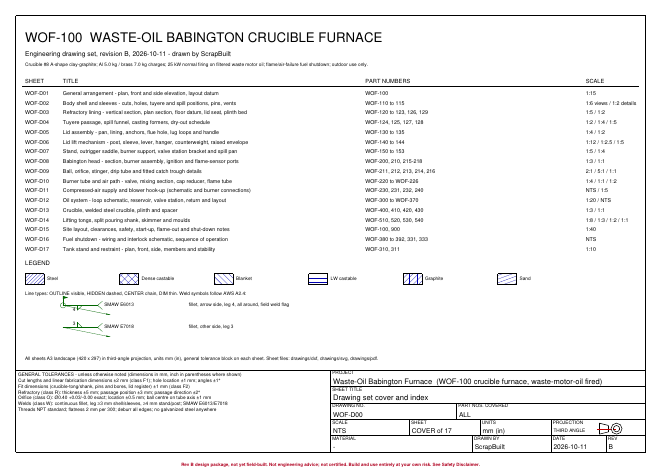

Rendered WOF-100C drawing sheet, drawing preview / page 1
Drawing preview / page 1

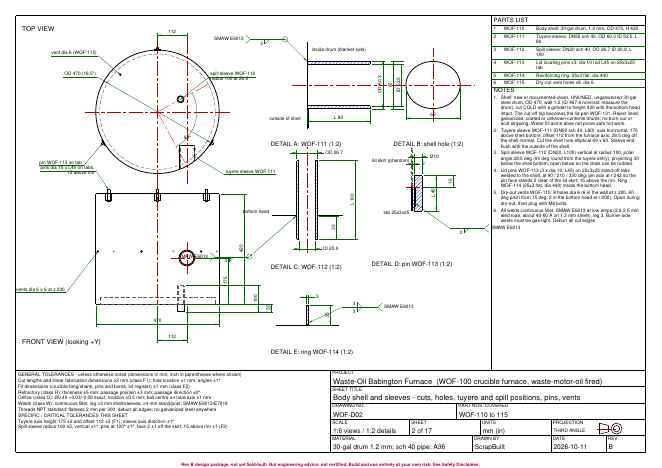

Rendered WOF-100C drawing sheet, drawing preview / page 3
Drawing preview / page 3

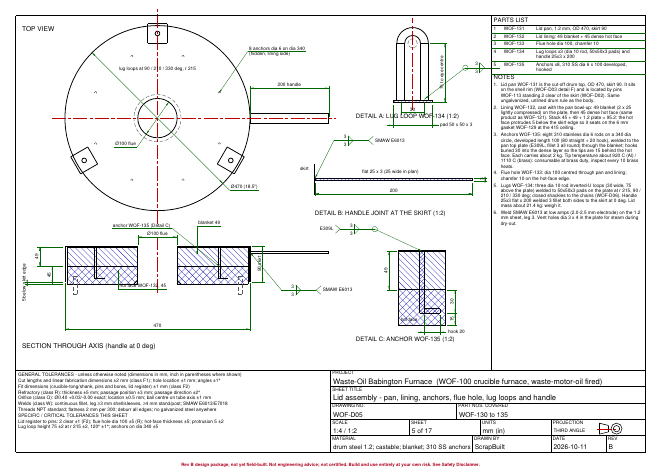

Rendered WOF-100C drawing sheet, drawing preview / page 6
Drawing preview / page 6

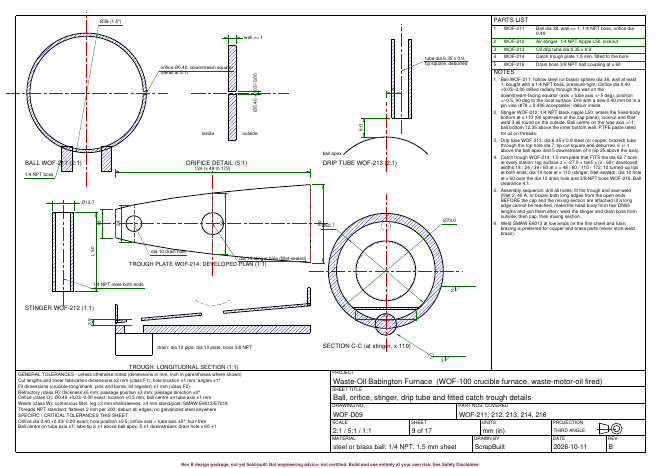

Rendered WOF-100C drawing sheet, drawing preview / page 10
Drawing preview / page 10

02 / DESIGN NUMBERS

Put the estimates in perspective.

Design estimates only, based on first-order hand calculations (±30%). These are not measured performance results.

Estimated build cost
About $1,556 scavenged, including $246 PPE; about $2,840 bought (cheapest buy option for each part, including $314 PPE).
Burner design firing rates
12 / 25 / 38 kW
5 kg aluminum melt estimate
49–76 min from cold; 17–28 min hot (high / normal fire)
Capacity
Designed for 5 kg Al / 7 kg brass (brass needs high fire, a chamber ≤ 1200 °C and two people)
Brass melt estimate
7 kg brass ~69 min cold, 23 min hot, high fire (estimate)
Crucible
#8 clay-graphite
Operating location
Outdoors only
Fuel
Filtered used engine oil from a known source
Materials
30-gal drum, salvage and some purchased parts

03 / CHOOSE YOUR FILES

One purchase. Your workshop project.

Free sample Founder (code FOUNDER25) Plans PDF Pro
Price $0 25% off Plans or Pro (first 25 orders) $39 $69
Contents, 1 drawing, parts excerpt, pre-run safety checklist ✓ ✓ ✓ ✓
All 26 A3 sheets (cover/index + 25 drawings) + build guide + safety + calcs + BOM (PDF) ✓ ✓ ✓
26 DXF CAD files with Pro ✓
Parts spreadsheet (.xlsx + .csv) with Pro ✓
First field-built revision Free Discounted Discounted
14-day no-questions refund — ✓ ✓ ✓

Prices in USD; tax added at checkout by the merchant of record.

Founder offer: use code FOUNDER25 for 25% off Plans or Pro, first 25 orders. Founder buyers also get a free update to the first field-built revision.

Every buyer gets free errata for Rev C. Founder buyers (code FOUNDER25) get a free update to the first field-built revision; others get a discounted upgrade. No fixed date for that revision.

04 / BEFORE YOU START

Workshop questions.

Has this furnace been built?

No. Furnace V1 is a Rev C design package, not yet built or fire-tested. It was designed, calculated and drawn, then checked by two automated (AI-run) design reviews: one on the numbers (33 findings) and one on the drawings and guide (28 findings). Every finding has been dealt with on paper, but 27 of the fixes can only be confirmed by a physical test on a real build. Four findings on the control wiring are on hold until the actual relay parts are chosen and reviewed. The fix register lists 8 open risks (see below). The first real build is next. Founder buyers get a free update to the first field-built revision, which will include what that build teaches.

Why Rev C and not Rev B?

Rev C is a paper revision of Rev B. Its main change is a stronger flame-safety chain:

  • a UV flame detector replaces Rev B's cad cell, which could mistake a glowing furnace for a flame;
  • a safety relay that needs a manual START after every trip;
  • a separate 15 s light-up timer;
  • two oil valves in series;
  • an air switch that proves real air flow.

It also has:

  • a screw-together pipe-fitting burner with a MIG-tip nozzle;
  • no welding on the thin drum;
  • a lighter lining and a swing-arm lid with no chains or counterweight;
  • oil feed down to 5 °C;
  • the tank moved to 3 m in a spill tray.

Rev C costs more to build than Rev B. The flame-safety chain is a design feature, not a safety guarantee: it has not been wired or tested, and no certified safety rating is claimed.

So why buy it now?

Only if you want a detailed, documented starting point and are comfortable building from an unproven design. Founder pricing (code FOUNDER25: 25% off Plans or Pro, first 25 orders) reflects the risk. If it is not what you expected, you get your money back within 14 days, no questions.

What can it melt?

Nothing has been melted in it yet. It is designed for a 5 kg aluminium charge of recovered metal (dry, crushed cans, added in small batches) or a 7 kg brass/bronze charge.

  • Brass needs high fire (38 kW), and the chamber must be kept at or below 1200 °C (measured with a thermocouple) to keep the lining's temperature margin. The full crucible weighs 11.8 kg against a 12 kg lift limit, so it is a two-person lift.
  • Cast iron and steel are out of scope.
What are the open risks?

The fix register lists 8:

  1. No wiring/firing release yet. The exact compatible relays, safety-relay inputs, air-switch contacts and UV-control terminals are not yet chosen or reviewed. The custom 120 V control panel needs a competent, component-specific electrical review and fuel-isolated bench fault tests before it is wired or fired.

  2. Flame, air and oil safety depend on tests on the real build:

    • the UV eye must not see the ignition spark;
    • the flame signal must be steady at LOW;
    • detector temperature;
    • early and in-run flame loss;
    • welded-relay faults;
    • measured response time;
    • a separate leak test of each oil valve.

    The ≈ 17 mL of oil released on a flame failure is a model figure.

  3. The lining's temperature margin is conditional, and the castable datasheets govern. You need a non-oil heat source for dry-out. The chamber must stay ≤ 1200 °C, the hot spots ≤ 250 °C and the lid-tab skirt ≤ 450 °C. Inspect after heating cycles. There is no measured efficiency.

  4. The lifting tools are unproven and the lid motion is conditional:

    • crucible fit and mass;
    • a 25 kg proof test of the home-made tongs and shank;
    • a dry transfer rehearsal;
    • lid clearance, droop, latch and push tests;
    • two people for brass, ≤ 12 kg lift.
  5. Adding cans needs a full stop, purge and relight, which depends on working controls. Drying cans never proves hidden cavities are dry. Stop after a second unplanned lockout.

  6. Several things must be measured on site:

    • real compressor and blower performance;
    • cold-oil flow at the lowest tank level;
    • fitting availability and leaks;
    • atomizing air flow;
    • spill-tray volume;
    • site clearances.
  7. Welding on the thin drum is avoided by design, but the structural welds, bolts and added brackets and tools still need inspection.

  8. Costs are estimates ($1,556 scavenged / $2,840 bought) and above Rev B. The real controls, a dry-out heat source, local materials, shipping and tax may raise them.

How long does a melt take?

These are model estimates:

  • Aluminium 5 kg from cold: about 76 minutes at normal fire, 49 minutes at high fire.
  • Aluminium 5 kg, furnace already hot: 28 / 17 minutes.
  • Brass 7 kg (high fire): about 69 minutes cold, 23 minutes hot.
  • Adding cans: each addition costs a stop, purge and relight of about 3 minutes, so a hot aluminium melt with 4 or 6 can additions takes about 49 or 60 minutes.

These are first-order calculations (about ±30 % or worse), not measurements.

How much oil does it use?

About 1.2 / 2.6 / 3.9 litres per hour at low / normal / high fire (12 / 25 / 38 kW), and about 3.2 L for one cold aluminium melt at normal fire (model estimate). The 20 L tank lasts about 5 hours at normal fire. Log your real fuel use; the savings over Rev B are model numbers.

What does it cost to build?

The 85-line parts list estimates about $1,556 using salvage and scrap where sensible ($1,310 build + $246 of PPE), or about $2,840 by the cheapest buy route. The buy route still uses some tested used/surplus items, such as the UV parts and safety relay; buying those new retail brings it to about $3,150. The scavenged route also includes purchased parts:

  • dense and insulating castable, ceramic blanket and firebricks;
  • an air compressor with a rated receiver;
  • the flame-safety controls (about $405 scavenged / $793 bought);
  • the crucible and PPE.

Prices are estimates and were not quoted. The Pro spreadsheet lets you enter your local prices.

What skills and tools do I need?
  • Comfortable cutting and welding mild steel (none on the thin drum sheet).
  • Threaded pipe and compression fittings.
  • 120 V control wiring, plus a competent electrical review of the panel before it is wired.
  • Mixing and casting refractory.
  • Safe molten-metal practice.
  • A purchased compressor with a rated receiver (≥ 25 L/min, 0.9 SCFM, free air at 30 psi).

If any of that is new to you, get an experienced person involved.

What fuel does it use?

Filtered used engine oil from a known, traceable source. That means not "free oil" of unknown origin: the guide says to reject any oil you can't vouch for. A Babington burner atomizes it. The oil is settled for at least 7 days, then filtered through a 100-micron sock and a 100-mesh strainer. Burning used oil is regulated or banned in some places, so check your local rules first.

Is it safe?

No furnace that burns oil and holds molten metal is "safe". The safety measures are:

  • In the design: a UV flame detector and safety relay with manual restart, a separate light-up timer, two oil valves in series, air-flow proving, a sealed drain, a spill pan and a tank spill tray.
  • In the guide: commissioning tests that are release conditions, a dry-out schedule and a full safety section.

It is not certified and not professional engineering advice, the flame-safety chain has not been wired or tested, and you build and use it at your own risk. Outdoors only. Read the Safety Disclaimer before buying.

What's the difference between Plans PDF and Pro?

Pro adds the 26 DXF CAD files (cover/index + 25 drawings) and the parts spreadsheet (.xlsx/.csv). Take Pro if you use CAD, have parts cut by a shop, or want to price the build.

What file formats?

The Plans are a PDF: 26 A3 sheets (cover/index + 25 drawings), plus the guide. It prints fine at A3 or tabloid and is readable on screen. Pro adds DXF R2010 in mm, XLSX and CSV.

Metric or imperial?

Millimetres, kg and °C, with imperial in brackets where useful; pipe and fittings use the US sizes you buy them in.

Can I sell what I cast?

Yes. Castings and items you make with a furnace built from these plans are yours to sell. What you can't do is resell or share the plans or files, or sell furnaces built from them as a product without a commercial license.

Can I share the files with a friend or my makerspace?

No. The license is for one buyer. Your friend can buy their own copy, or get the free sample first.

What's in the free sample?

The cover, the full contents, one complete drawing sheet (WOF-C-D01 general arrangement), a parts-list excerpt and the pre-run safety checklist.

What's the refund policy?

14 days, no questions: email us or reply to your receipt. Founder buyers can also get a refund if no field-built revision is issued within 12 months of their purchase.

When is the field-built revision?

After the first real build and commissioning. There's no fixed date, and progress will be posted in public.

Who handles payment and tax?

Our merchant of record (Gumroad) processes payment, adds and remits sales tax/VAT where required, and delivers the files instantly by download link and email.

I found an error.

Please email [email protected]. Confirmed errors are fixed in free errata for Rev C for every buyer.

Start with the free sample.

The cover, the Safety Disclaimer, the first page of what changed from Rev B, the full contents, the drawing index and one complete drawing sheet (general arrangement), a parts-list excerpt and the pre-run safety checklist.

Get the free sample ($0+)

Gumroad captures the email.
